Getting Started

The Project Module in Invizion Accounting is used to track work that involves multiple steps, people, and transactions. A project brings together tasks, time, materials, deliveries, and billing under a single reference.

The example below shows how a simple manufacturing job can be managed as a project and how it connects with other Invizion Accounting modules.

Scenario**:**

A manufacturing company receives an order to make a custom metal storage rack for a warehouse customer.

Prerequisites:

  • Create an Item - Storage Rack

Step 1: Create a Sales Order for the rack

  • To create a sales order, go to:

Home > Selling > Sales Order

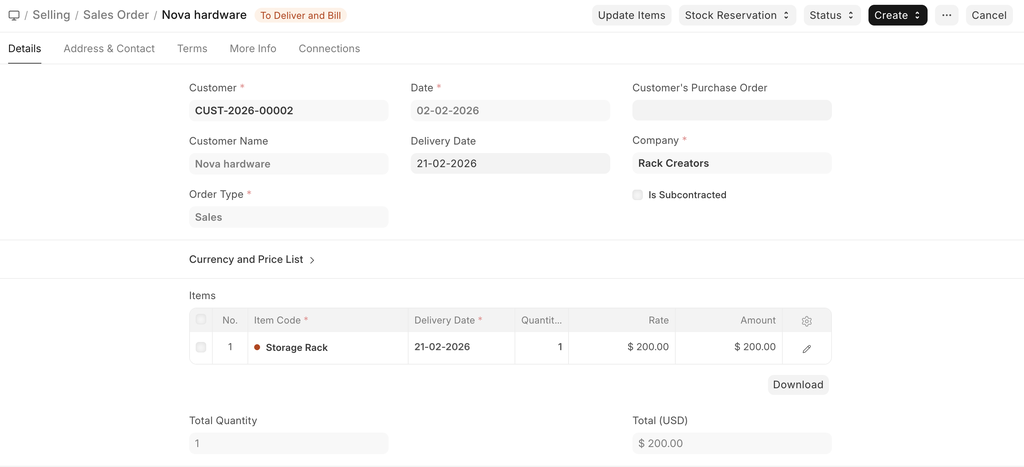

Sales order with the Storage Rack

Step 2: Create the project from the Sales Order

  • After the sales order is submitted, we can create the project from it

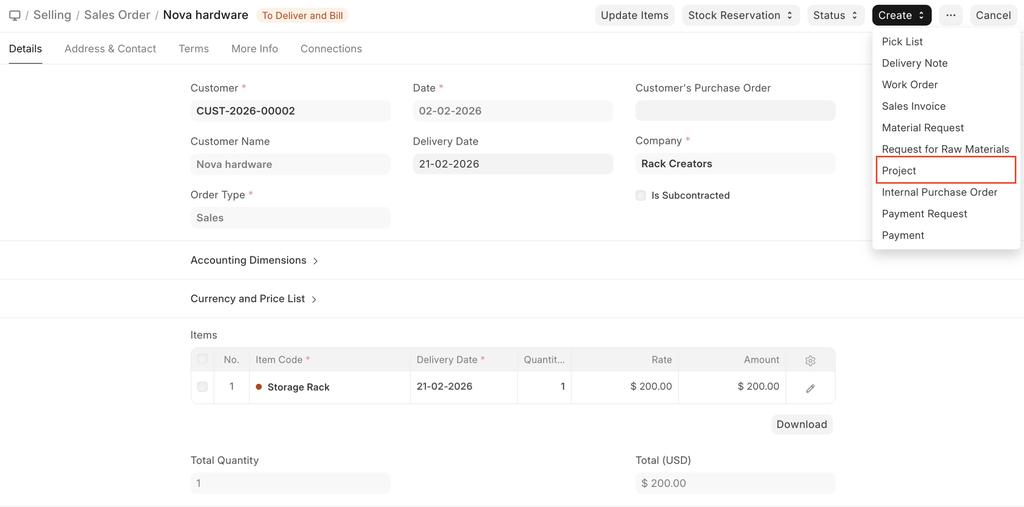

  • Creating project from Sales Order
  • Once the project is created, the dashboard will be created, which will allow the creation of tasks and timesheets

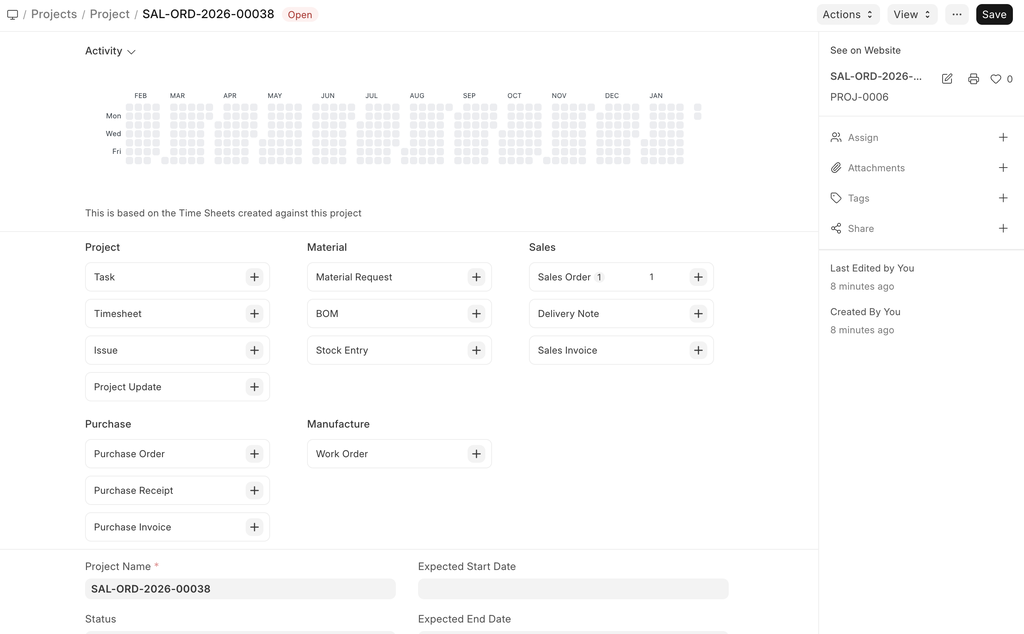

  • Project Dashboard

Step 3: Creating the Basic Tasks for the project

  • We create separate tasks for the project, like cutting and welding, painting, and final assembly.

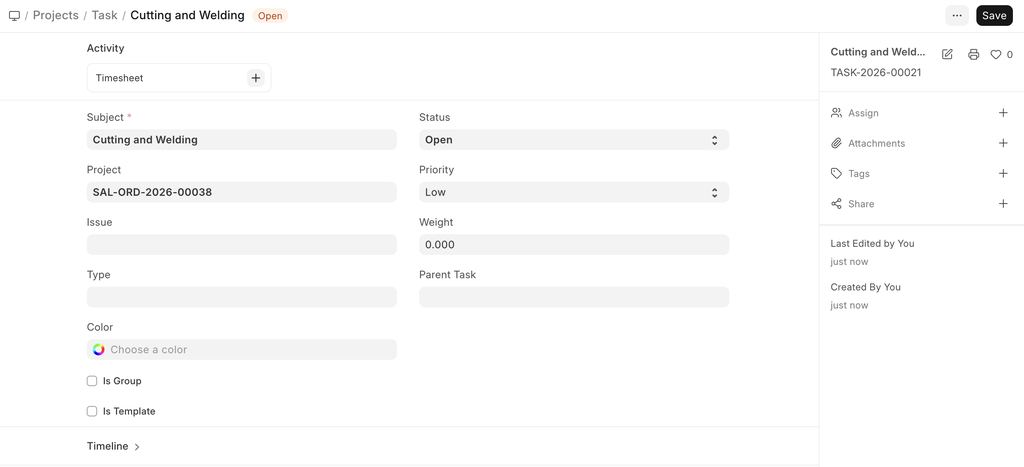

  • Task for Cutting & welding

Step 4: Create purchase orders for the raw materials and respective stock entries as well

  • The raw material required for making the Storage rack would be purchased, therefore the purchase order would be made for the same

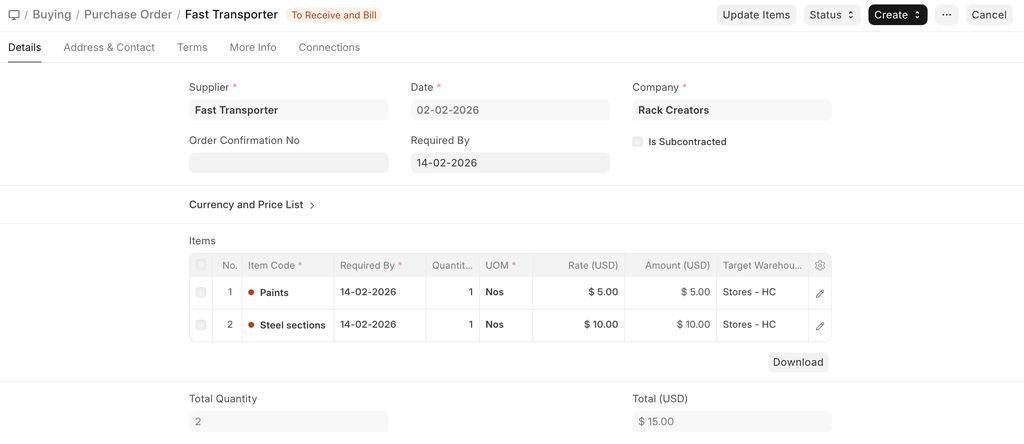

  • Purchase order for raw material

Step 5: Create a timesheet to record the execution of steel sections and paints

  • To maintain the execution of the steel sections and the painting of the storage rack, we create a timesheet
  • The changes made in this project will reflect the costing and billing details

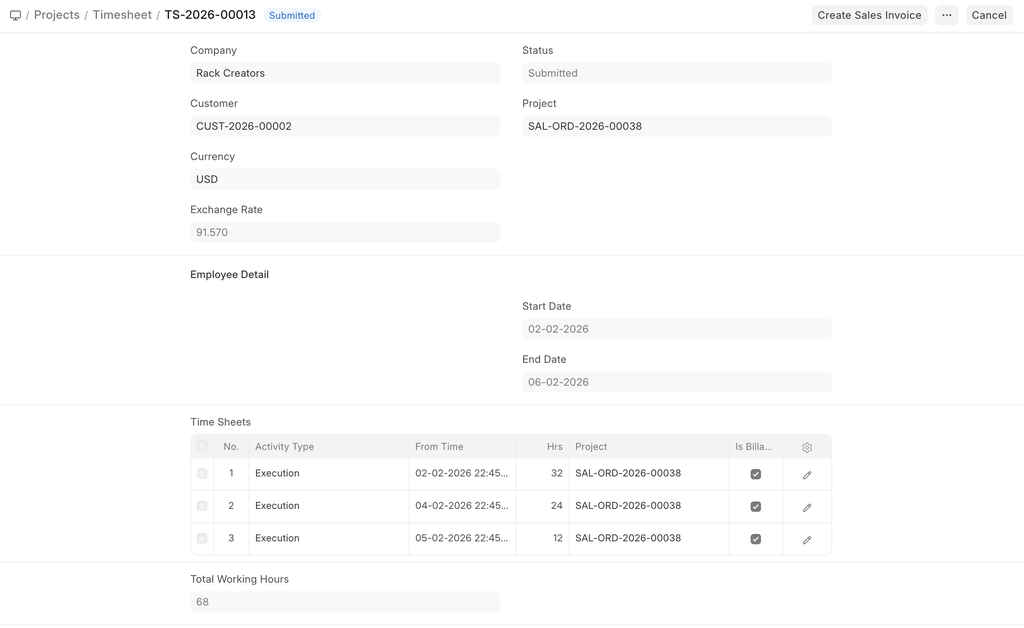

  • Execution details in timesheet

Step 6: As the process continues, we update the task with its progress

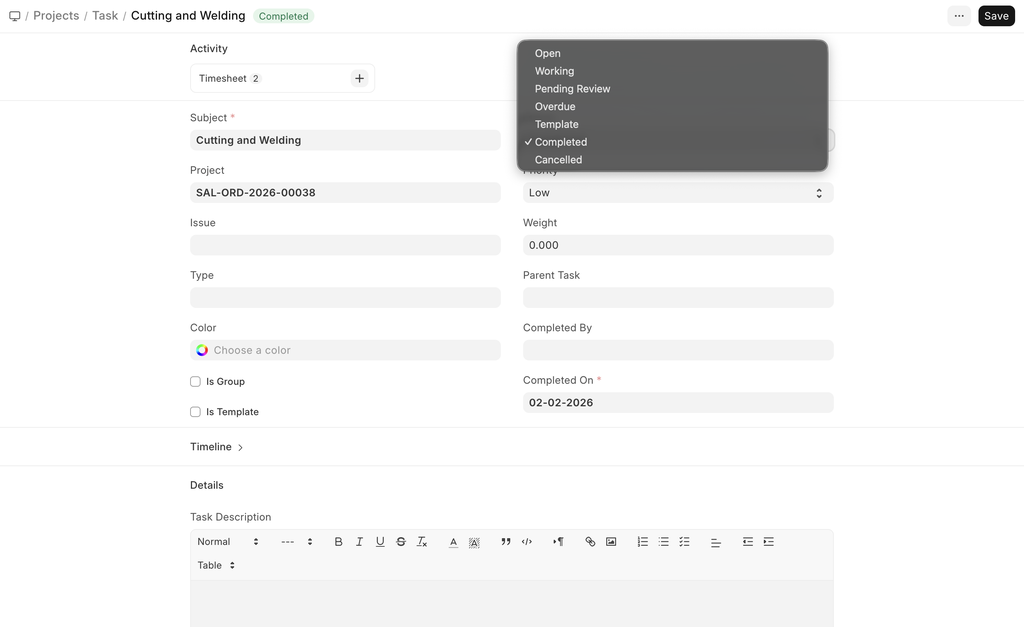

*Task Status *

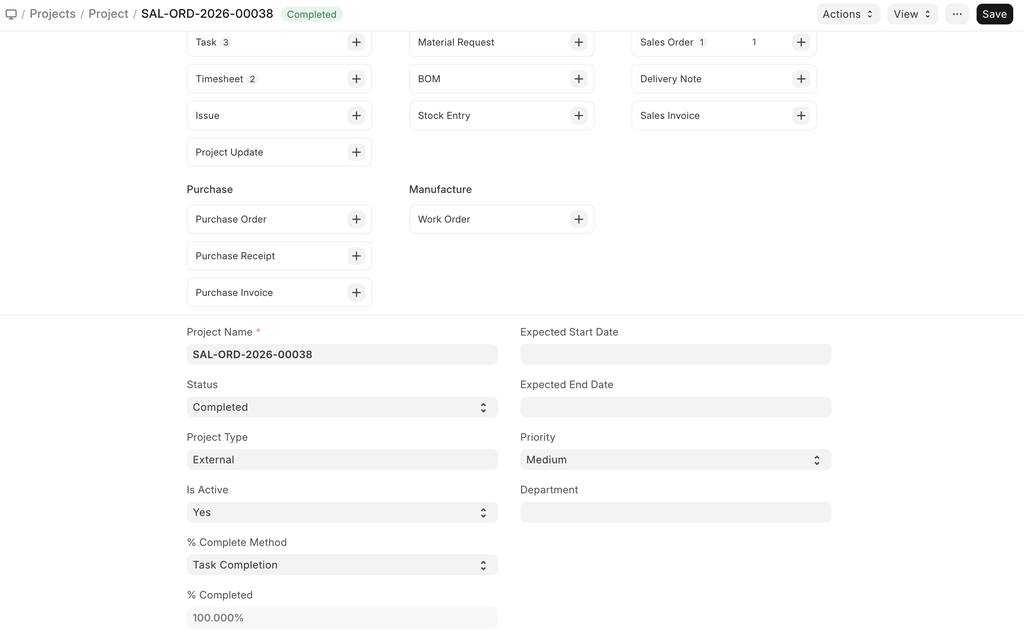

  • Once all the tasks are completed, the project moves into a fully completed state as well

Final Project Status

Last updated 5 months ago
Was this helpful?
